Jurisdiction: Abandoned Mine Lands
2006 Completed Projects Archive
Beulah/Zap - Phase 10
The Commission entered into two contracts for the Beulah/Zap Phase 10 abandoned mine project. One contract required the contractor to drill holes into underground mined workings and to pump grout to fill mine cavities south of Zap. The second contract required the contractor to perform field and lab testing of the grout that was used for this project. Holes totaling 17,166 feet were drilled and 1640 cubic yards of grout was injected into mine voids. The work was completed between June 8 and September 9, 2006. The drilling, grouting and testing work was completed at a cost of $299,383.20.
Williams County Road 9 - Phase 1
The Commission entered into two contracts for the Williams County Road 9, Phase 1, abandoned mine project. One contract required the contractor to drill holes into underground mined workings and to pump grout to fill mine cavities east of Williston. The second contract required the contractor to perform field and lab testing of the grout that was used to fill the mine cavities. Holes totaling 30,134 feet were drilled and 2500 cubic yards of grout was injected into mine voids. The work was completed between September 21, 2006 and June 5, 2007. The contracted work was completed at a total cost of $348,250.70.
Columbus - Phase 7
The Commission entered into a contract for Phase 7 of the Columbus AML Site to reclaim approximately 20 acres of abandoned highwalls and pit. Approximately 105,000 cubic yards of spoil material was moved during reclamation. Dirt work at the Columbus Phase 7 AML site started on June 1, 2006, and was completed August 30, 2006. The contracted work was completed for a total cost of $238,050.00.
Maintenance/Mine Investigations
The Commission also conducted a sinkhole filling project in 2006. The contractor filled approximately 4150 cubic yards of sinkholes at abandoned underground mines near Baldwin, Beulah, Dickinson and Wilton. Work on this project started on November 29, 2005 and was completed on May, 20, 2006. The sinkhole filling work was completed for $18,329.50.
Eagles Oversight Investigation

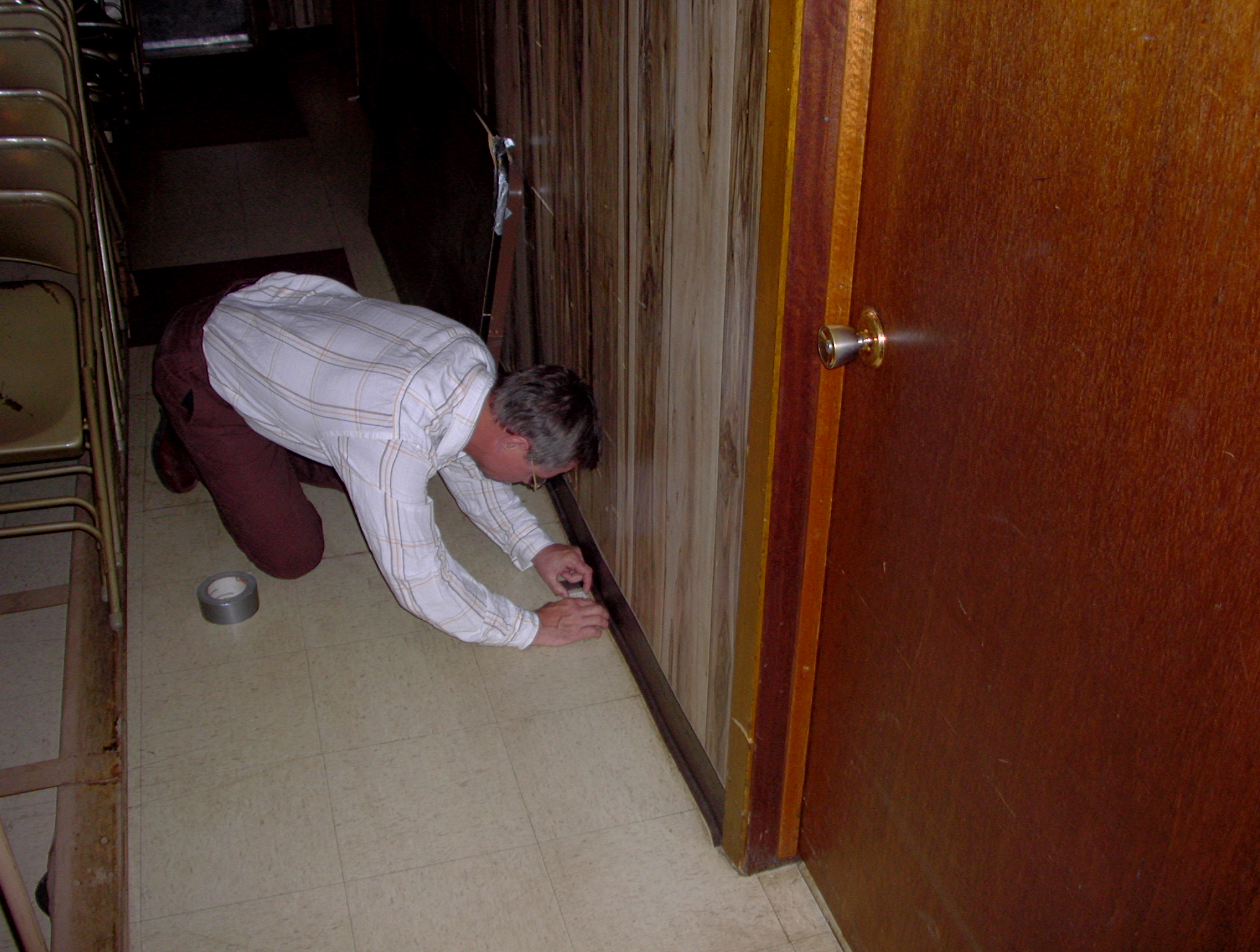

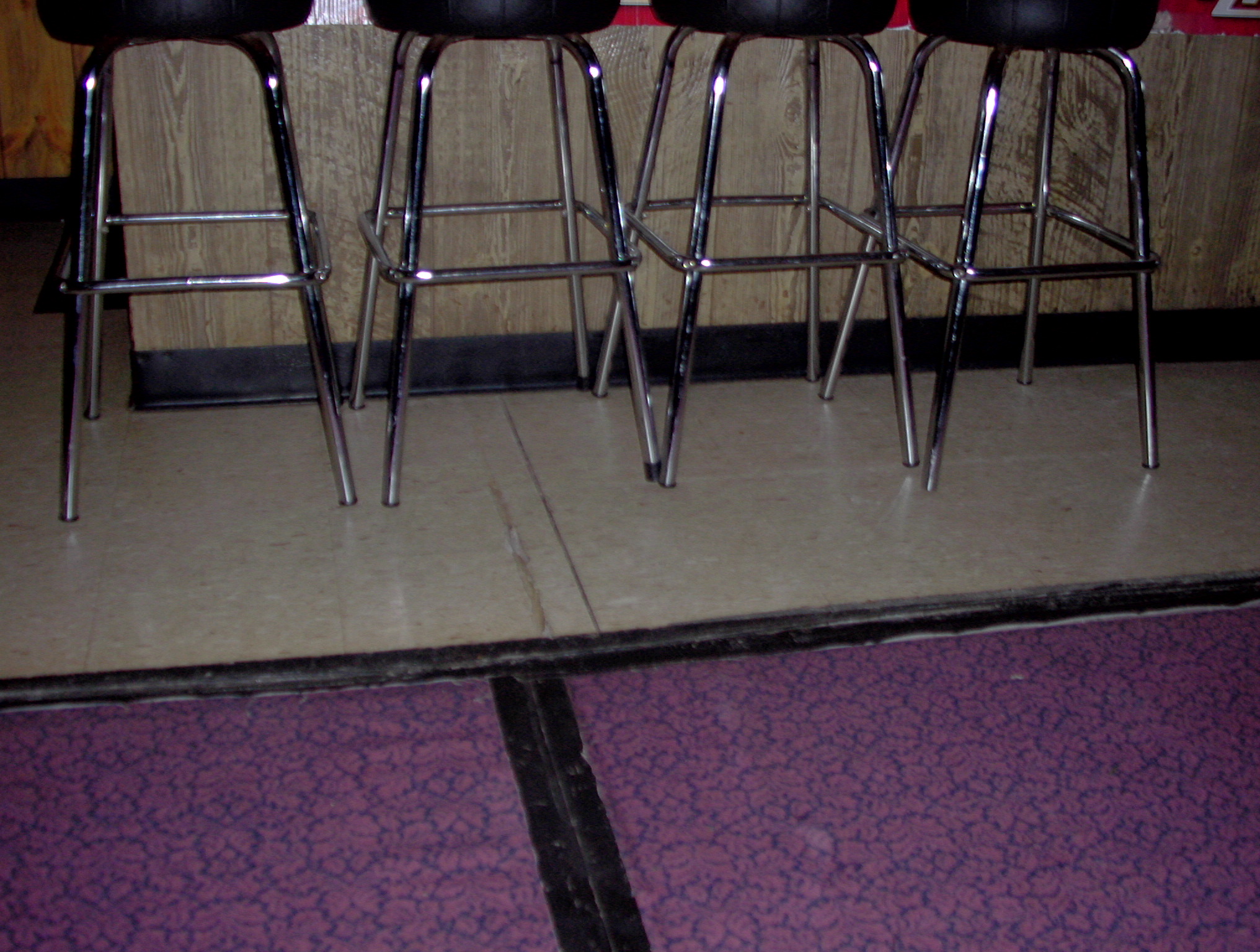

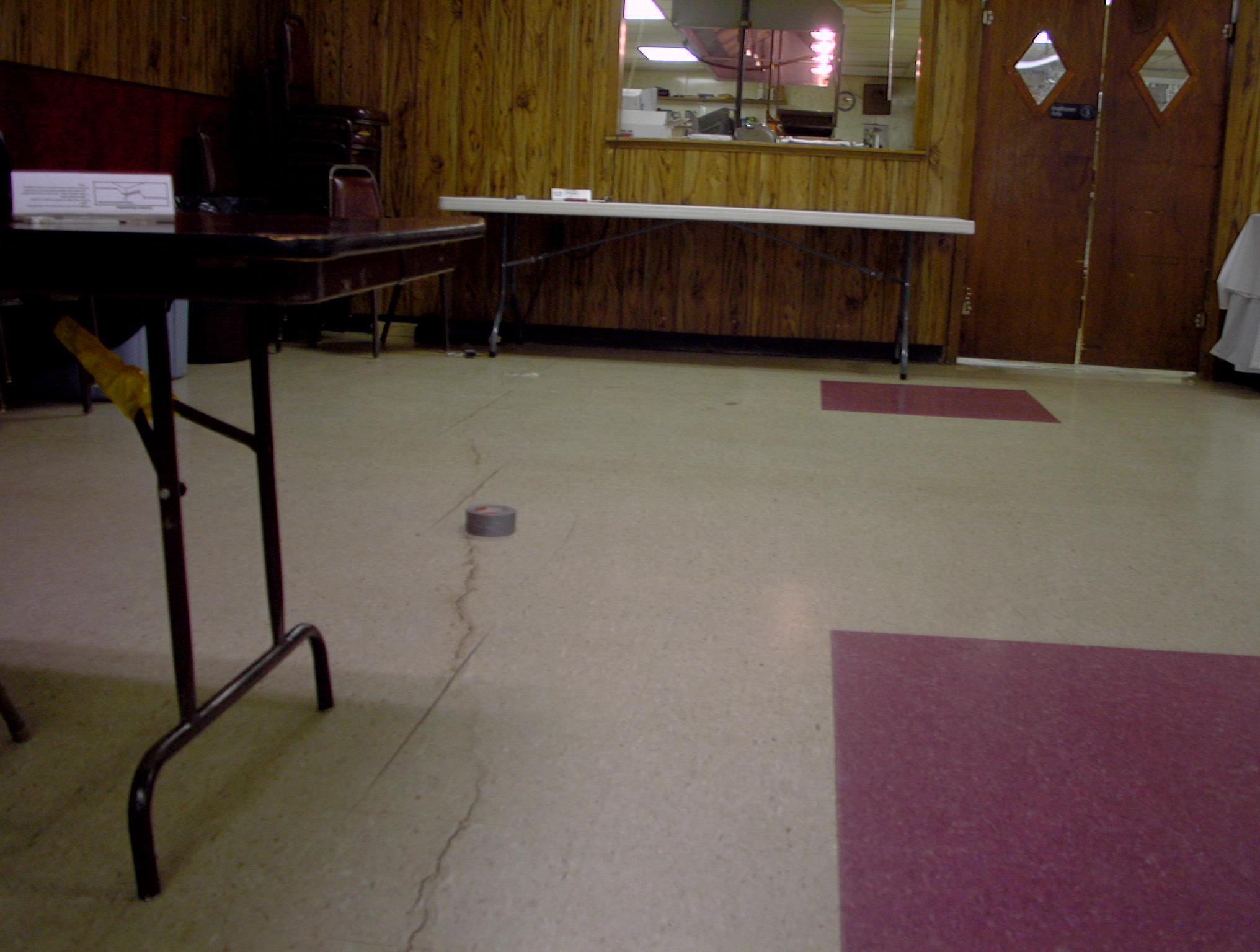

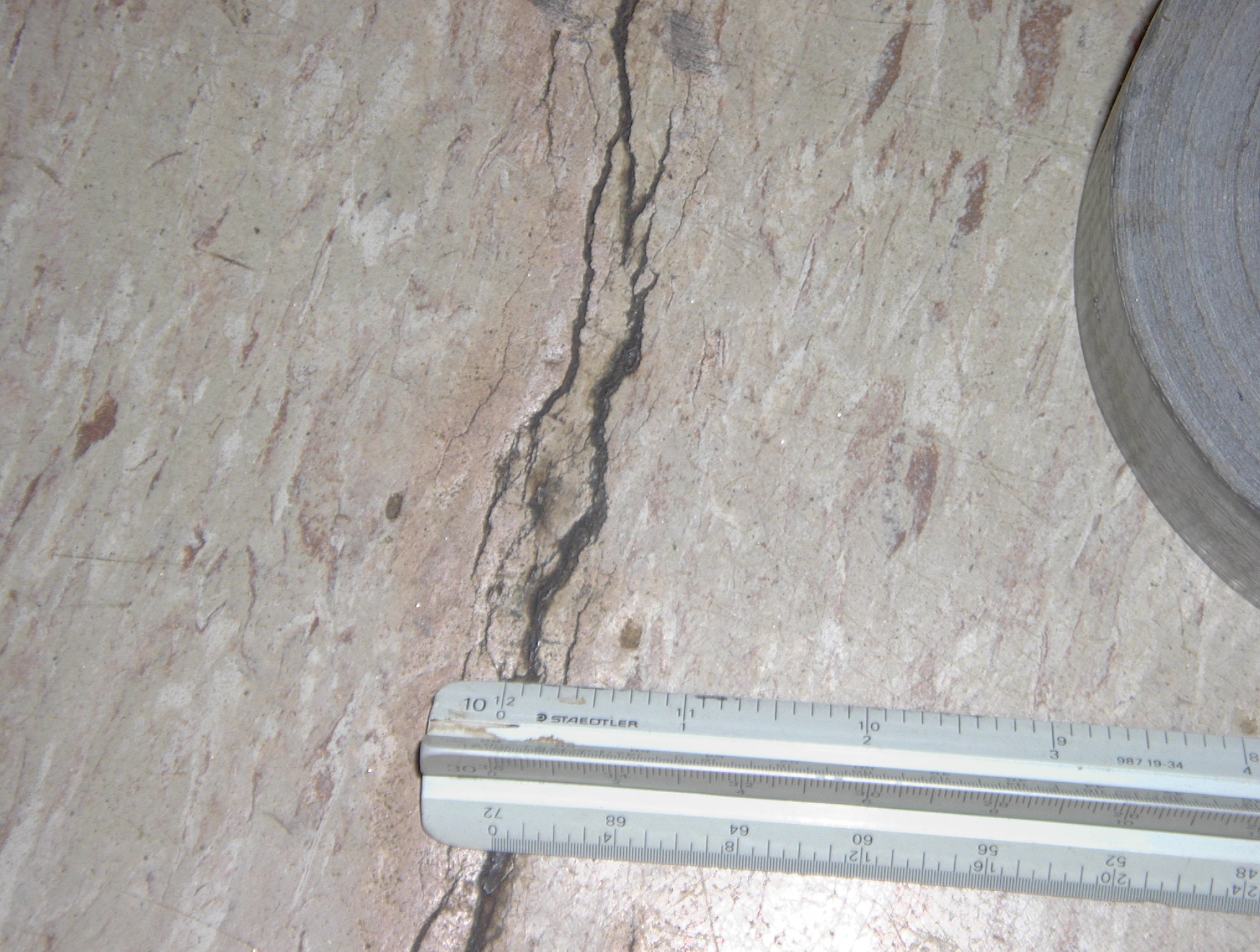

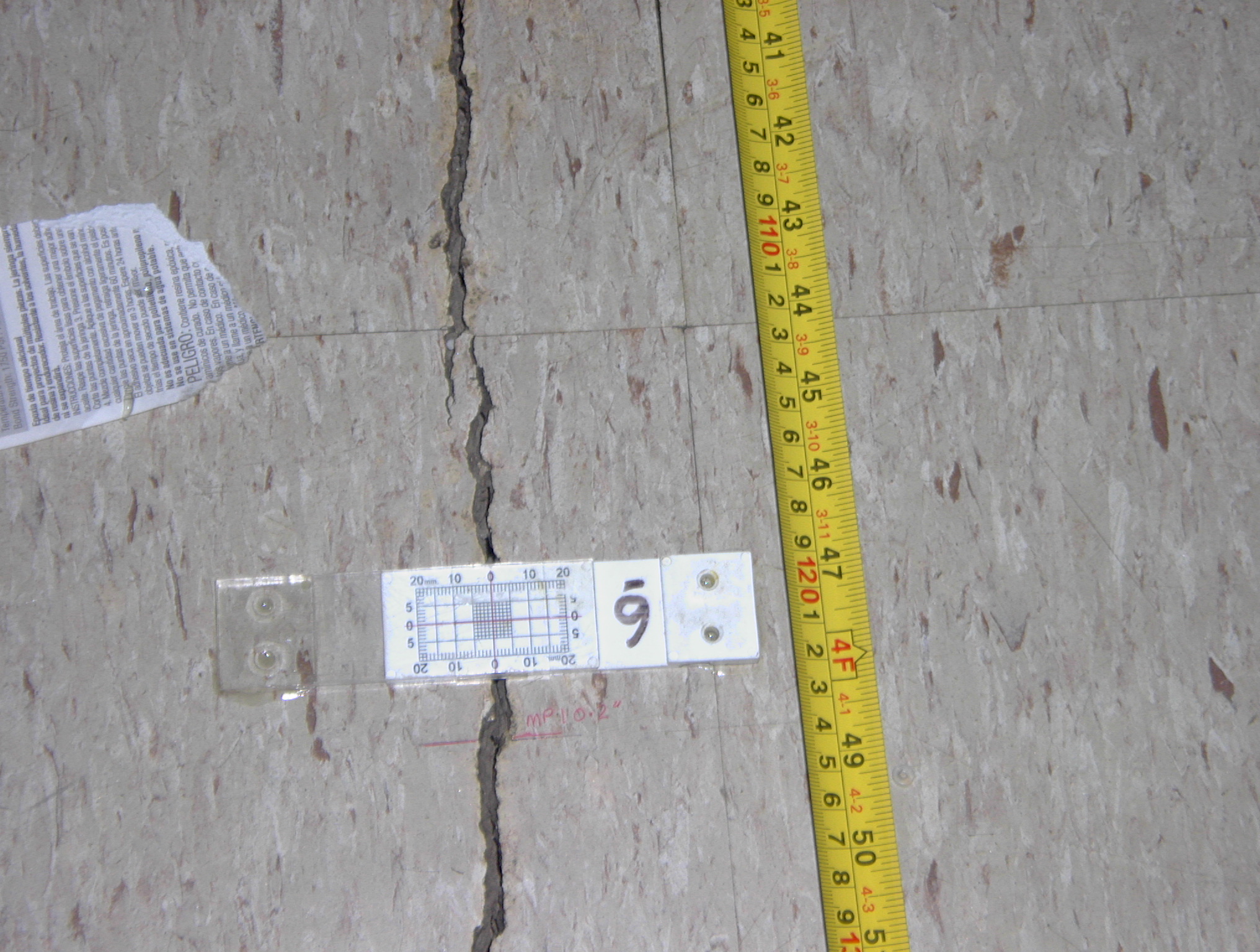

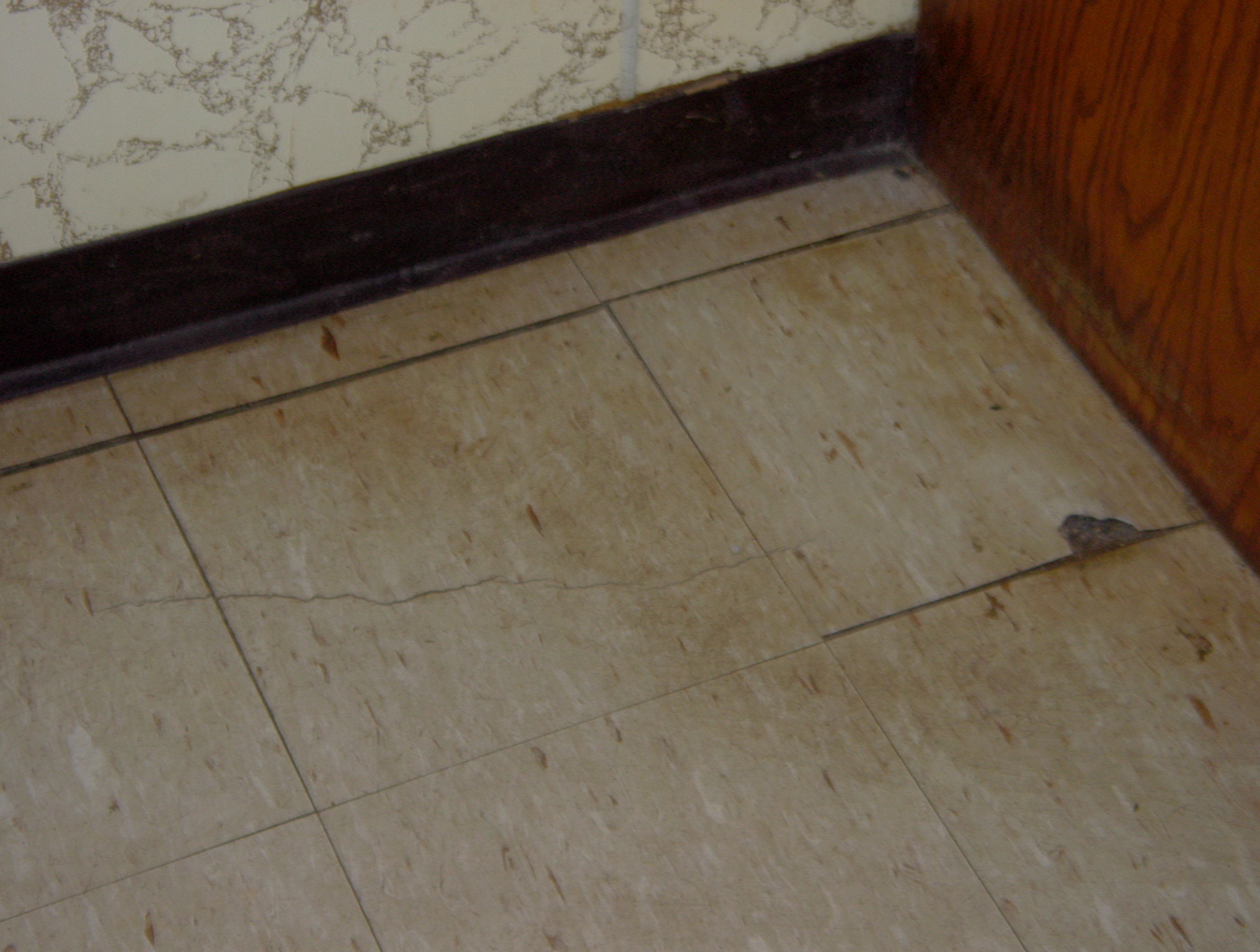

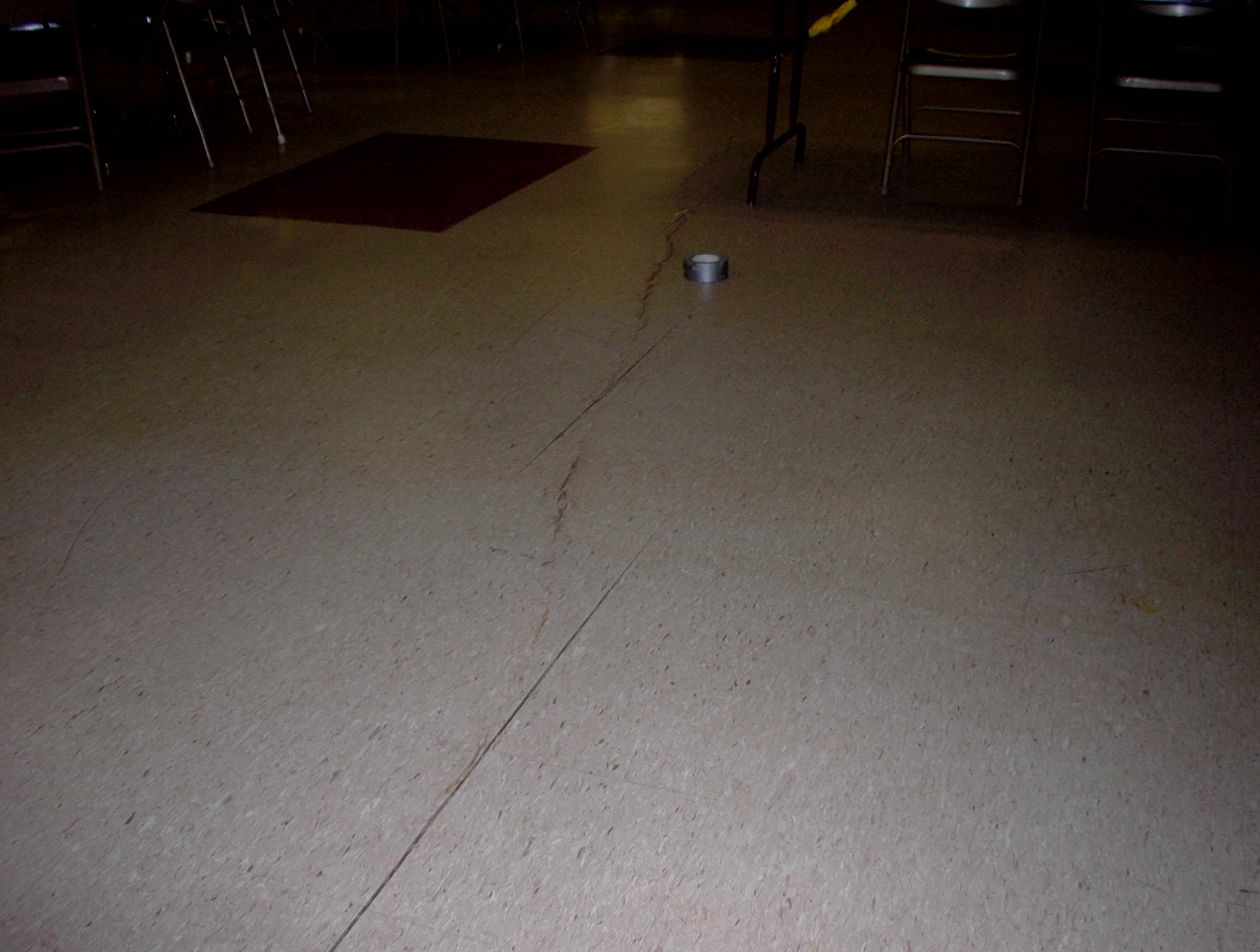

Bill Dodd and Bruce Beechie inspected the Eagles Club on June 5. The area of concern was in the main hall at the northeast corner of the building. Tile separations and radial cracking are evident. They installed two crack monitors. One is located in the main hall near the kitchen access window and the other is located about 2 ½ feet north of the men's restroom at the northeast corner of the building in the hallway. The crack in the dining room floor appears to be a separation joint. The widest crack is below MP-1 near the kitchen access window and measures .2 inch or approximately .5 centimeters. Photographs were taken of the cracks/separations.
Loren Daede, City of Beulah Engineer and Shirley Oyen, Eagles Club Manager were present. Shirley said she would keep and eye on the crack monitors and do her best to protect them. Bill Dodd and Bruce Beechie will periodically check the crack monitors and keep a log of measurements. The following are pictures of the floor:
